Takt time, cycle time, and lead time are three of the most important flow metrics in Lean, manufacturing, service operations, and continuous improvement. They are related, but they answer different management questions. Takt time defines the pace required by demand. Cycle time shows what the process actually does. Lead time shows what the customer experiences from request to receipt.

This guide rebuilds the full practitioner reference from the source PDF, including formulas, worked calculations, line-balancing logic, Little's Law, office and service examples, common mistakes, improvement levers, a self-assessment, quick reference tables, and frequently asked questions.

View the Guide Open the takt gap analyzer

Back to Guides

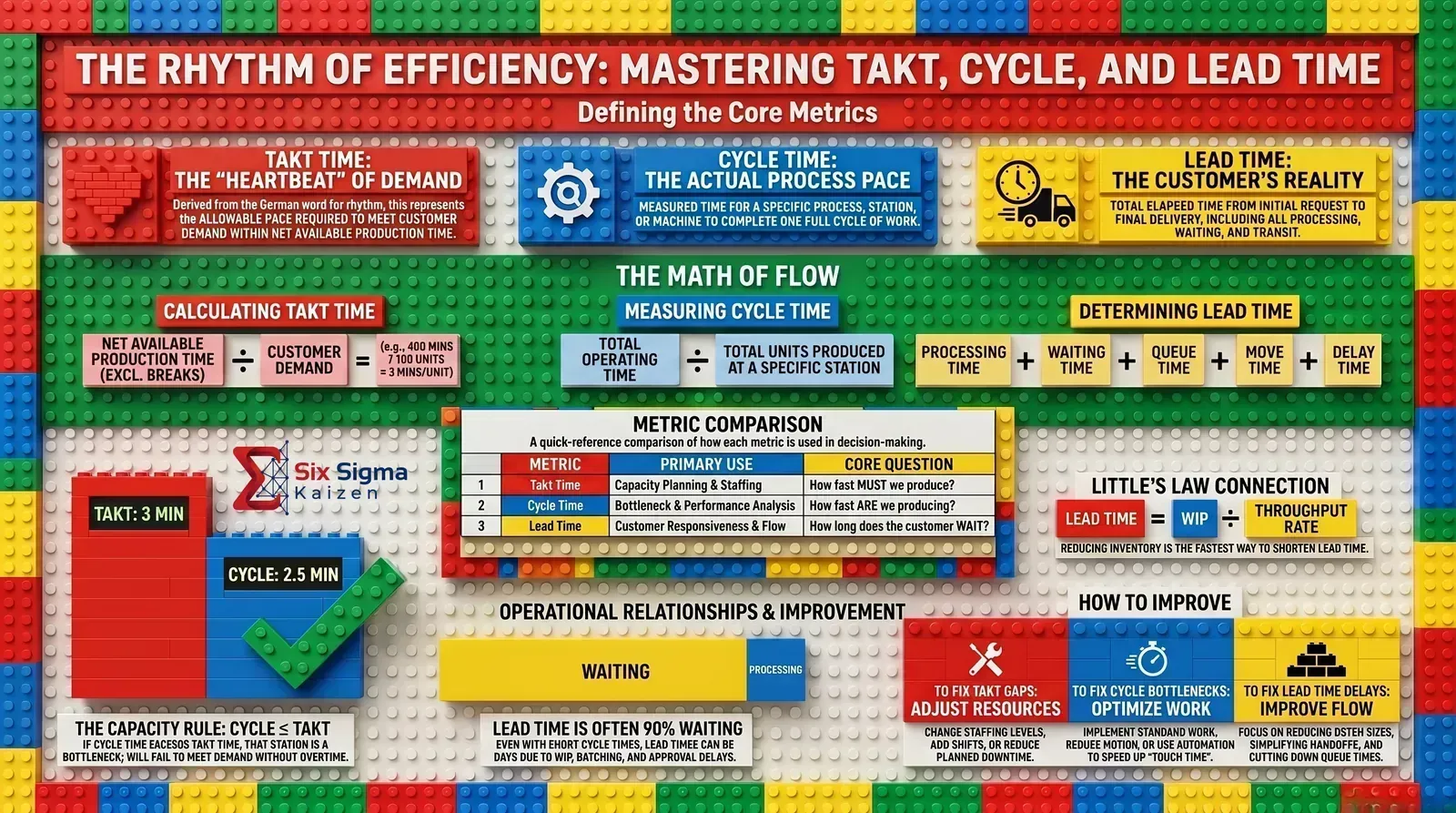

Infographic and Slide Deck

The infographic summarizes takt time as the demand heartbeat, cycle time as the actual process pace, and lead time as the customer's elapsed experience. It also includes the core formulas, Little's Law connection, and the practical improvement levers for takt gaps, cycle-time bottlenecks, and lead-time delays. Click the image to enlarge it.

View the Guide

Jump to Guide Sections

Introduction: The Three Most Commonly Confused Flow Metrics

Takt time, cycle time, and lead time appear constantly in production conversations, improvement reports, value stream maps, staffing discussions, and customer delivery reviews. The confusion is understandable: all three involve time, all three are used in Lean systems, and all three influence capacity and service performance. But each one answers a different question and drives different decisions.

Confusing them creates predictable operational damage. Teams build staffing plans for the wrong pace, promise customers based on processing time instead of total wait time, push operators harder when the real problem is queue time, and report dashboards that make the system look healthier than the customer experience actually is.

The practitioner rule: takt time is demand pace, cycle time is process pace, and lead time is end-to-end elapsed time.

MetricCore Question It AnswersWhat It RepresentsWho It Drives Decisions For
Takt timeHow fast do we need to produce?The allowable pace required to match customer demand with available work time.Production planning, line design, staffing, and capacity management.
Cycle timeHow fast are we actually producing or processing?The actual measured time to complete one cycle of work at a station, machine, cell, or process.Operations, industrial engineering, standard work, and bottleneck analysis.
Lead timeHow long does the customer wait?Total elapsed time from the moment a request enters the system until the customer receives the output.Customer service, scheduling, flow improvement, and WIP management.

The Three Metrics at a Glance

Lead time is everything the customer waits through. Cycle time is only the active work inside that wait. Takt time is the required beat the system must hit, independent of what is happening inside any single unit's journey.

Lead Time everything the customer waits through Cycle Time only the active processing segments Takt Time the required beat, regardless of what is inside it
Three different views of the same flow: lead time is the full wait, cycle time is the work inside it, and takt time is the pace the system is required to hold regardless.

Section 1: Takt Time

Demand pace: the required rhythm to satisfy the customer.

Takt time comes from the German word Takt, meaning rhythm or beat. In Lean, takt time defines the required production rhythm needed to meet customer demand with the time available to work. It is the tempo of the production system.

Takt time is not how fast the machine runs and not how fast a worker currently performs the operation. It is the target pace the system must achieve if it wants to keep up with demand without overproducing. It is derived from customer demand and available work time, not from current process capability.

What it isThe required production pace: the amount of time allowed to produce one unit if the process is to keep up with customer demand over the available work period.
What it is notIt is not current process speed, machine cycle time, or actual output rate. It is the target pace set by demand.
Why it mattersIt anchors staffing, number of stations, equipment quantity, shift structure, standard work, and line balancing.
What changes itCustomer demand changes, available production time changes, shifts are added or removed, or planned downtime changes.
Typical unitsMinutes per unit, seconds per unit, or hours per job, depending on the time period used.

1.1 Takt Time Formula

Takt Time = Net Available Production Time / Customer Demand

Both inputs must use the same period. Use available minutes per shift with units demanded per shift, available minutes per day with units demanded per day, or available hours per week with units demanded per week.

1.2 Worked Calculation Examples

Example 1: Single-shift manufacturing line

InputValueNotes
Gross shift time480 minutes8-hour shift
Less: scheduled breaks30 minutesTwo 15-minute breaks
Less: team meeting10 minutesDaily production meeting
Less: planned cleaning5 minutesEnd-of-shift 5S activity
Net available production time435 minutes480 - 30 - 10 - 5 = 435
Customer demand145 units per shiftDemand allocated to this shift
Takt time3.0 minutes per unit435 / 145 = 3.0 min/unit

Result: the line must complete one unit every 3.0 minutes, on average, to satisfy demand. Every station design, staffing decision, and work-content allocation should reference this target.

Example 2: Two-shift operation with variable demand

ScenarioNet Time Per ShiftDemand Per ShiftTakt Time
Baseline430 min120 units3.58 min/unit
Demand increases 20%430 min144 units2.99 min/unit; must accelerate significantly
Demand decreases 15%430 min102 units4.22 min/unit; pace can slow or staffing can be reviewed
One hour of overtime added490 min120 units4.08 min/unit; takt loosens with more time
Short shift390 min120 units3.25 min/unit; takt tightens with less time

Takt time is sensitive in both directions. Increasing demand or reducing available time tightens takt. Decreasing demand or adding available time loosens takt. It must be recalculated whenever the inputs change.

1.3 The Four Rules of Takt Time

RuleDescriptionWhy It Matters
Use net available time, not grossSubtract planned non-production time such as breaks, meetings, cleaning, planned downtime, and shift change loss where applicable.Using gross time overstates capacity and creates unexplained production shortfalls.
Match time period to demand periodIf the numerator is minutes per shift, the denominator must be units demanded per shift.Mismatched periods create a numerically wrong takt calculation.
Recalculate when inputs changeReview takt when demand, shift structure, planned downtime, or seasonal patterns change.A stale takt gives wrong staffing and balancing decisions.
Takt is a target, not a guaranteeTakt tells you what pace the system must achieve; capability depends on cycle time, uptime, quality, and changeover.The takt formula does not prove the process can meet demand.

1.4 Takt Time and Strategic Planning

Beyond shift-level planning, takt time is a strategic capacity-planning tool. The question "How many shifts, lines, or facilities do we need to meet projected demand?" is answered by comparing projected takt requirements to actual process capability.

If the current best cycle time is 4.5 minutes and projected demand requires a takt of 2.8 minutes, the current process cannot meet demand even at full speed. That is a strategic capacity signal: add capacity, redesign the process, improve OEE, or challenge the demand forecast. It is not a signal to simply push people harder.

Section 2: Cycle Time

Process pace: what the process actually does.

Cycle time is the actual elapsed time required for a process, station, machine, or worker to complete one cycle of work. Teams use it to describe how long it takes to make one part, complete one transaction, or perform one repeatable process step.

Because cycle time can refer to a single station, a machine, a person, a cell, or an entire repeated process segment, context matters. Always specify which cycle time is being discussed.

Industrial engineer timing a production station with a stopwatch next to a whiteboard labeled Pace
Cycle time has to be observed directly, not estimated — an engineered standard can hide the variation that actually matters.
What it isThe actual measured time to complete one unit of work at a process step, station, machine, cell, or combined process segment.
What it is notIt is not takt time, lead time, or order-to-delivery elapsed time.
Why it mattersCycle time compared against takt reveals bottlenecks, capacity headroom, and standard work opportunities.
Measurement requirementObserve it directly. Do not rely only on engineered standards or estimates.
Variation mattersReport average, minimum, maximum, range, and ideally standard deviation. An acceptable average can hide dangerous variation.

2.1 Cycle Time Formulas

Direct Observation Cycle Time = Observed Time to Complete One Unit

Rate-Based Cycle Time = Total Operating Time / Total Units Produced

The rate-based form is useful when direct observation is impractical or historical production records are available. Direct observation is preferred for standard work because it captures variation that averages can hide.

2.2 Types of Cycle Time

Cycle Time TypeWhat It MeasuresUse CaseCommon Mistake
Manual cycle timeOperator active work time on one unit, excluding machine-run time while the operator is idle.Standard work, operator loading, ergonomic study.Confusing manual time with total station cycle time.
Machine cycle timeTime a machine or automated system takes to complete its operation on one unit.Equipment capability, OEE, machine capacity.Reporting machine time as station time when the operator is the constraint.
Station or cell cycle timeTotal time from when a unit enters a station or cell until it exits.Line balancing, bottleneck identification, takt comparison.Treating station time as fixed when it varies by mix, operator, or shift.
Process cycle timeTotal time to complete a sequence of value-adding operations from first step to last.Value stream mapping and process capability.Confusing process cycle time with lead time.
Administrative or transactional cycle timeActive processing time for one request, case, or transaction.Office and service process improvement.Treating processing time as lead time when the case waited before processing.

2.3 Worked Calculation Examples

Example 1: Station cycle time from production data

Observation window120 minutes of production time
Units produced38 units
Calculated cycle time120 / 38 = 3.16 minutes per unit
Takt time3.0 minutes per unit
Comparison3.16 min > 3.0 min; this station is a bottleneck.
ImplicationAt this cycle time, the station can produce at most 37.9 units per hour, short of the 40 units per hour required by takt.

Example 2: Multi-observation cycle time study

MeasureValueInterpretation
Observed cycle times2.85, 3.10, 2.92, 3.45, 2.88, 3.02, 2.79, 3.18, 2.95, 3.08 minTen observed cycles across normal production.
Average3.02 minBarely above a 3.0-minute takt.
Minimum2.79 minBest observed performance and possible standard work target.
Maximum3.45 minWorst observed performance; creates throughput risk.
Standard deviationApproximately 0.19 minModerate variation; investigate the causes of long cycles.

This is why averages alone are insufficient. A process averaging 3.02 minutes may appear barely capable, but cycles at 3.45 minutes will create WIP buildup when takt is 3.0 minutes.

2.4 Cycle Time vs. Takt Time

ComparisonInterpretationRequired Action
Cycle time < takt time, significantlyThe station has capacity headroom. This can be useful buffer or inefficient overcapacity.Assess whether the capacity is needed; consider moving work from overloaded stations.
Cycle time near takt timeThe station is close to demand pace, but variation can push it above takt.Monitor closely and control variation.
Cycle time > takt timeThe station cannot keep up with demand at current performance.Improve standard work, reduce motion, redistribute work, add resources, or add capacity.
Multiple stations > takt timeThe line is fundamentally under-resourced for current demand.Conduct systemic capacity assessment; individual station fixes are not enough.

Section 3: Lead Time

Customer experience: the full elapsed wait from request to receipt.

Lead time is the total elapsed time from the moment a request, order, or need enters the system until the customer receives the output. It includes active processing time plus waiting, queueing, batching, transportation, release delay, review delay, and any other time the work spends sitting in the system.

Lead time is often the metric that matters most to the customer. A process can have excellent cycle times and still disappoint customers if queue time, batching, or scheduling delays dominate the total elapsed time.

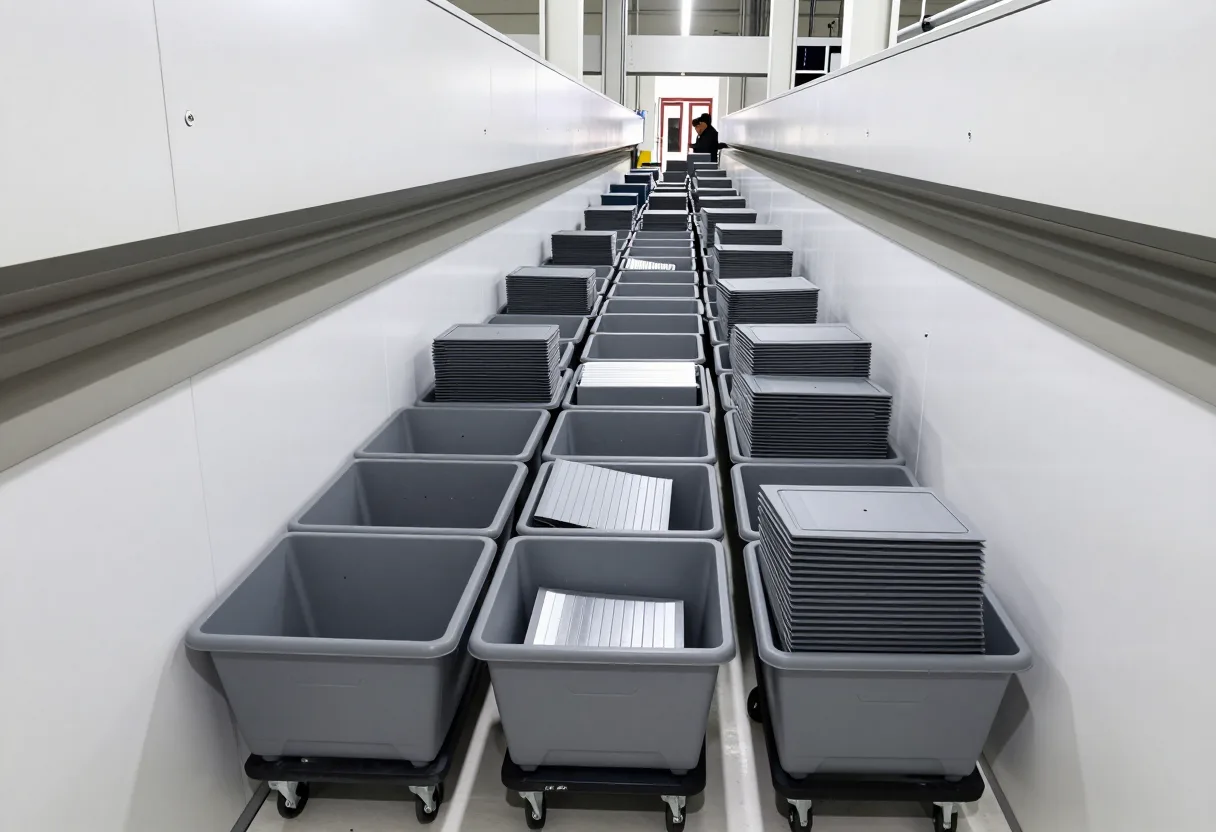

Long queue of work-in-process bins stacked on rolling carts waiting in a factory aisle between stations
This is where lead time actually lives — not in the processing step, but in the queue of parts waiting their turn.
What it isThe complete elapsed time from customer request or order entry to completed delivery.
What it is notIt is not cycle time or processing time. It includes every form of waiting.
Why it mattersIt drives delivery commitments, customer responsiveness, cash-to-cash cycle time, and customer satisfaction.
The uncomfortable truthIn many manufacturing and service processes, value-added processing time is only 3% to 15% of total lead time.
Lead time decompositionProcessing time + queue/waiting time + batch accumulation + transportation + approval or release delay.

3.1 Lead Time Formula

Lead Time = Processing Time + Waiting Time + Queue Time + Move Time + Delay Time

The right approach is to measure lead time directly from order entry to delivery, or to decompose it by mapping each time component in the flow.

3.2 Lead Time Decomposition Examples

Example 1: Manufactured part

A machined metal part takes 22 minutes of processing time across four manufacturing operations, but the average customer order-to-delivery lead time is 12 days. The decomposition below shows where time is consumed.

PhaseTimeTypeImprovement Signal
Order entry queue8 hrNon-value-addedQueue discipline and release logic.
Material receiving2 hrValue-added or requiredMaintain flow and avoid downstream staging.
Material staging queue16 hrNon-value-addedWIP and scheduling opportunity.
Machining Op 14 hrValue-addedProcessing step.
Inter-operation queue12 hrNon-value-addedFIFO, smaller batches, and pull signals.
Machining Op 25 hrValue-addedProcessing step.
Inspection queue10 hrNon-value-addedQueue reduction and inspection scheduling.
Inspection3 hrValue-added or requiredAssess sampling and quality-at-source options.
Finishing operation4 hrValue-addedProcessing step.
Shipping queue / batch wait14 hrNon-value-addedBatch-release opportunity.
Outbound shipping transit14 hrNon-value-added from process perspectiveLogistics and shipment frequency review.
Total lead time92 hr100%Only about 20% involves actual processing work.

The biggest opportunities are shipping batch wait, order entry queue, and inter-operation queues. These are flow and WIP problems, not operator speed problems.

Example 2: Service process - insurance claim

Time ComponentElapsed TimeValue-Added?Root Cause of Delay
Claim submission to assignment1.5 daysNo; queueClaims received in batches with first-come-first-served queue.
Active intake review18 minutesYesNormal processing time.
Assignment to adjuster queue2 daysNo; queueAdjusters have high open case loads.
Field assessment visit2.5 hoursYesNecessary value-adding work.
Assessment report preparation45 minutesYesNormal processing time.
Report to coverage review1 dayNo; batchCoverage review is processed in batches.
Coverage review decision1 hourYesNormal processing time.
Decision to approval queue0.5 daysNo; queueSupervisor approval queue builds.
Payment authorization30 minutesYesNormal processing time.
Payment processing and delivery2 daysNo; system delayPayment batch processing runs twice weekly.
Total lead time~8.5 days5.3 hours VA / 8.5 days totalApproximately 8% process efficiency.

3.3 Lead Time and Little's Law

Lead Time = Work in Process (WIP) / Throughput Rate

If throughput rate is fixed by the bottleneck, the most direct way to reduce lead time is to reduce WIP. When WIP accumulates because of batching, imbalance, or scheduling logic, lead time rises even if each individual process step is performing to standard.

ScenarioWIPThroughput RateLead TimeInsight
Current state450 units100 units/day4.5 daysHigh WIP creates long lead time.
Reduce WIP by 50%225 units100 units/day2.25 daysLead time halves without changing speed.
Increase throughput by 25%450 units125 units/day3.6 daysFaster throughput helps, but WIP remains costly.
Both improvements225 units125 units/day1.8 daysCombined WIP and throughput work gives the strongest result.

A common lead-time mistake is trying to reduce total lead time by speeding up operators. If processing is only 10% of total lead time, a 20% cycle-time reduction improves total lead time by only about 2%. WIP, batching, and queue reduction often deliver much larger results.

Section 4: How the Three Metrics Relate

The real power is in reading all three metrics together. Takt tells you what must happen, cycle time tells you what the process is doing, and lead time tells you what the customer experiences.

Combination ObservedWhat It Tells YouLikely Root CausesPriority Action
Cycle time > takt, lead time shortA bottleneck exists, but WIP may not have accumulated yet.Recent demand increase, process degradation, or short observation window.Address the bottleneck before WIP builds.
Cycle time <= takt, lead time longStep performance is adequate, but the system has poor flow.Batch release, approval delays, scheduling gaps, upstream bottleneck, or poor flow design.Map lead-time components and attack queues.
Cycle time > takt, lead time longClassic overloaded system: bottleneck plus WIP buildup.Demand exceeds capacity, multiple bottlenecks, poor line balance.Address capacity and accumulated WIP together.
Cycle time <= takt, lead time shortHealthy system: capable, balanced, and flowing.Good balancing, pull systems, low batch sizes, minimal approval delays.Maintain and continue improving.
Takt unknown, cycle and lead measuredPlanning is disconnected from demand.Demand has not been translated into takt.Calculate takt and reframe performance relative to demand.

4.2 Full Example: Reading the Three Metrics Together

A medical device assembly line runs 9-hour shifts. Breaks and meetings account for 60 minutes, leaving 480 minutes of net available time. Customer demand is 160 units per shift.

MetricValueInterpretation
Takt time480 / 160 = 3.0 min/unitThe line must complete one unit every 3 minutes.
Station 1 cycle time2.5 min/unitBelow takt; 17% faster than required.
Station 2 cycle time3.4 min/unitAbove takt; bottleneck.
Station 3 cycle time2.8 min/unitBelow takt; adequate capacity.
Station 4 cycle time3.1 min/unitSlightly above takt; at risk.
Lead time6.5 daysCustomer waits 6.5 days even though active processing is under 30 minutes per unit.

Station 2 prevents the line from achieving takt. Station 4 is at risk. The long lead time is likely caused by WIP accumulation upstream of Station 2 plus batch scheduling in outbound logistics. The plan must address both the cycle-time bottleneck and the lead-time contributors.

4.3 The Line Balance Chart

A line balance chart compares station cycle times against takt time. It shows the bottleneck, capacity headroom, and balance efficiency in one view.

Takt 3.0 min 2.6 Station 1 OK 3.4 Station 2 Bottleneck 2.9 Station 3 OK 3.1 Station 4 At risk
Station 2 sits well above the 3.0-minute takt and is the hard bottleneck; Station 4 is close enough to takt that normal variation could push it over too.
StationCycle TimeRelative to 3.0-Min TaktStatus
Station 12.6 min0.4 min below taktOK
Station 23.4 min0.4 min above taktBottleneck
Station 32.9 min0.1 min below taktOK
Station 43.1 min0.1 min above taktBottleneck risk

Total work content is 12.0 minutes. Maximum station cycle time is 3.4 minutes. Balance Efficiency = 12.0 / (4 stations x 3.4 min) = 88%. That means 12% of available station time is lost to imbalance.

Section 5: Line Balancing Using Takt Time

Line balancing distributes work content across stations so every station can complete its work within takt time, with roughly similar cycle times. Perfect balance is theoretical; practical balance means eliminating stations significantly above takt while minimizing idle time and overburden.

5.1 Assembly Line Detailed Example

A line runs an 8-hour shift. Planned breaks and meetings are 60 minutes. Net available time is 420 minutes. Customer demand is 140 units per shift. Takt time is 420 / 140 = 3.0 minutes per unit.

Analysis ItemCalculation / Finding
Takt time3.0 minutes per unit
Current station timesStation 1 = 2.6, Station 2 = 3.1, Station 3 = 2.9, Station 4 = 3.4 min
Total work content2.6 + 3.1 + 2.9 + 3.4 = 12.0 minutes
Minimum theoretical stations12.0 / 3.0 = 4.0 stations
Bottleneck stationStation 4 at 3.4 min, 13% above takt
Secondary bottleneckStation 2 at 3.1 min, 3% above takt
Expected actual throughput420 / 3.4 = about 124 units per shift, versus 140 required
Shortfall16 units per shift, or 11.4% below demand
Line balance efficiency12.0 / (4 x 3.4) = 88.2%

The improvement strategy should reduce Station 4 below 3.0 minutes through standard work, motion reduction, or work-content rebalancing. Station 1 has headroom and may be able to absorb some work from Station 4.

5.2 After Balancing: Improved State

MetricBefore BalancingAfter BalancingImprovement
Station cycle times2.6, 3.1, 2.9, 3.4 min2.9, 2.8, 2.9, 2.8 minAll stations now below takt.
Bottleneck cycle time3.4 min2.9 min14.7% reduction.
Expected throughput124 units/shift420 / 2.9 = 145 units/shiftExceeds demand of 140 units.
Line balance efficiency88.2%11.4 / (4 x 2.9) = 98.3%10.1 percentage-point improvement.
Total work content12.0 min11.4 min0.6 min eliminated.

The rebalanced line now exceeds takt requirements and has a small buffer to absorb normal variation.

5.3 Balancing Principles

  • Overloaded station: if cycle time exceeds takt, the station constrains output below demand.
  • Underloaded station: if cycle time is far below takt, it may be able to absorb work from overloaded stations.
  • Balance efficiency: total work content / (number of stations x bottleneck cycle time). 95% or higher is excellent; below 85% signals significant imbalance.
  • When rebalancing is constrained: add a parallel resource, change sequence, redesign the process, or add capacity at the bottleneck.

Section 6: Office and Service Applications

These metrics are not manufacturing-only concepts. They apply wherever repeatable work flows: customer service, claims processing, software development, healthcare, financial services, HR, maintenance, supply chain, and administrative operations.

6.1 Office and Service Worked Example

A team processes customer change requests. Net available time per day is 390 minutes (8.5-hour day minus breaks and planned meetings). Customer demand is 30 requests per day.

MetricCalculationResultInterpretation
Takt time390 / 3013 minutes/requestOne request must be completed every 13 minutes on average.
Average cycle timeObserved analyst active work11 minutes/requestBelow takt; active processing capacity appears adequate.
Lead timeSubmission to completion over 20 requests2.8 days averageCustomers wait nearly 3 days for an 11-minute task.
Process efficiency11 min / (2.8 days x 390 min/day)1.0%Only 1 in 100 minutes involves actual work.

The cycle-time data says the team has processing capacity. The lead-time data says the system does not have flow.

6.2 Lead Time Decomposition for the Change Request Process

PhaseTimeTypeImprovement Meaning
Submission to assignment10 hrNon-value-addedAssignment queue delay.
Active intake review2 hrValue-addedProcessing work.
Assignment queue / analyst backlog18 hrNon-value-addedLargest delay; workload management opportunity.
Active analysis and processing9 hrValue-addedProcessing work.
Approval queue16 hrNon-value-addedManager queue and SLA opportunity.
Manager approval action1 hrValue-added or requiredNecessary decision work.
System update and notification3 hrValue-added or requiredCompletion work.
Notification queue9 hrNon-value-addedBatch email delay.
Total lead time68 hr100%Only 15 hours, or 22%, involve actual work.

Three focused interventions could remove most of the delay: reduce analyst backlog through workload management, implement a 4-hour approval SLA with visual management, and switch from batch notification to real-time notification.

6.3 Transactional Self-Assessment

QuestionHow to Answer ItTarget State
What is our takt time?Net available time per period / requests per period.Known and refreshed when demand or available time changes.
What is actual cycle time?Time multiple active processing instances.Measured, documented, and compared to takt.
What is actual average lead time?Track submission date/time to completion date/time for at least 20 transactions.Measured and decomposed into components.
What percentage of lead time is value-added?Average cycle time / average lead time x 100%.Improvement target identified; 30%+ is excellent for many service processes.
Where are the largest non-value-added time components?Identify each waiting and delay component separately.Top three components have improvement owners.

Section 7: Common Mistakes

The most damaging mistakes are not only calculation errors. They are conceptual errors: using the wrong metric for the decision, merging terms that measure different things, and applying the wrong improvement lever.

MistakeWhy It Is WrongImpactBetter Practice
Calling takt time the same as cycle timeTakt is demand-derived; cycle time is measured process output.Staffing and capacity decisions lose connection to customer demand.Always compare cycle time against takt; do not use the terms interchangeably.
Using gross shift time for taktGross shift time overstates productive time.Takt appears too lenient and production shortfalls become hard to explain.Calculate net available time and document all deductions.
Reporting only average cycle timeAverages conceal variation and outliers.The bottleneck looks manageable while the line falls behind during long cycles.Report average, minimum, maximum, range, and standard deviation.
Ignoring queue and wait time in lead timeProcessing time is not lead time.Customers experience delays the dashboard does not show.Measure from customer request to customer receipt and decompose the time.
Reducing lead time by speeding operatorsMost lead time is waiting, not active processing.Ergonomic and quality risk rise while total lead time barely changes.Attack WIP, batching, approvals, scheduling gaps, and handoff delays.
Setting takt once and never updating itDemand and available time change.Staffing and balancing become disconnected from current demand.Review monthly and recalculate when demand or time changes materially.
Using process cycle time for customer commitmentsThe customer experiences total lead time, not active processing time.Promises are missed and trust is damaged.Base customer-facing commitments on lead time.

Section 8: Improving Each Metric

Each metric has different improvement levers. Do not apply a cycle-time lever to a lead-time problem unless processing time is truly the dominant contributor.

8.1 Responding When Takt Time Cannot Be Met

Response CategorySpecific LeversBest FitWatch Out For
Increase available timeAdd overtime, add shifts, extend shift length, or reduce planned non-production time.Large or permanent demand increase when other options are insufficient.Overtime degrades quality and is not sustainable as a primary solution.
Add capacityAdd parallel resource, additional line or cell, or automation.Demand is permanently higher than current capacity.Adding capacity without removing waste locks in higher cost.
Improve OEEReduce downtime, changeover, speed losses, and micro-stoppages.Equipment unreliability drives cycle time above theoretical minimum.Requires sustained maintenance and standard work.
Redesign the line or processRebalance work, move work from bottlenecks, eliminate steps, or enable parallel processing.Current design concentrates too much work in one place.Requires engineering resources and careful production planning.
Smooth demandLevel demand, strategically buffer peaks, or build ahead of predictable surges.Peaks are predictable and temporary.Can reduce responsiveness if overused.

8.2 Reducing Cycle Time

Improvement LeverDescriptionTypical Impact
Standard work development and complianceDocument the current best method, train operators, and audit adherence.5-15% reduction by removing technique variation.
Motion reduction and workplace designUse 5S, ergonomic design, and motion study to remove reach, walk, search, and regrasp.10-25% reduction where manual movement is significant.
Setup and changeover reductionApply SMED so changeovers consume less available time and enable smaller batches.Highly variable; strongest when changeover consumes a large portion of available time.
Tooling and fixture improvementUse fixtures, quick-change tooling, and poka-yoke positioning to remove awkward alignment and searching.5-20% reduction in assembly and machining with fixture content.
Automation of specific tasksAutomate repeatable tasks such as torque, press, weld, label, scan, or verify.Variable; strongest where repeatable machine work displaces manual time.
Training and skill developmentUse structured training and deliberate practice when operator skill limits cycle time.5-15% for skill-limited operations.

8.3 Reducing Lead Time

Improvement LeverDescriptionTypical Impact
Reduce WIPSet WIP limits, use kanban, and stop releasing work when downstream is full.40-70% lead-time reduction where WIP is uncontrolled.
Eliminate batch processingMove from large batches to smaller batches or single-piece flow.30-80% reduction in batch-dominated processes.
Simplify approval stepsRemove approvals that add no value and streamline necessary reviews.20-50% reduction when approval queues are significant.
Improve scheduling and priority logicUse FIFO, priority lanes, and more frequent smaller releases.10-40% reduction depending on current scheduling waste.
Reduce transportation and handoff delayCollocate steps, reduce distance, and use electronic handoffs where practical.10-30% reduction where movement and handoffs dominate.
Create pull systemsProduce only when downstream signals need instead of pushing inventory by schedule.50-80% WIP and lead-time reduction in stable pull systems.

Section 9: Self-Assessment, FAQ, and Quick Reference

9.1 Self-Assessment Questions

Assessment QuestionStrong AnswerWeak Answer - Action Required
Can your team define takt, cycle, and lead time without mixing them together?Each person can give a crisp, distinct definition.Definitions are merged or unclear; educate the team before improvement work.
Are takt calculations based on net available time?Deductions from gross time are documented and reviewed.Takt uses gross shift time or quota; recalculate using net time.
Do you know the real cycle-time bottleneck?A specific station is identified, gap to takt is quantified, and an improvement plan is active.Bottleneck is assumed; conduct line-balance observation.
Do dashboards separate lead time from processing time?Order-to-delivery lead time and active cycle time are distinct metrics.Only processing time is tracked; add end-to-end lead-time measurement.
Are teams attacking waiting and WIP, or only operator speed?Projects include WIP limits, batch reduction, and approval-time reduction.Projects focus only on operator method; redirect effort toward flow.
When demand changes, do staffing and balancing decisions change?Takt is recalculated and used in staffing decisions.Staffing is based on history or intuition; implement takt recalculation rhythm.

Takt, Cycle, and Lead Time Frequently Asked Questions

Can cycle time be lower than takt time?

Yes. In most well-designed lines, station cycle time should be at or slightly below takt so the line has a buffer against natural variation. A station consistently above takt is the problem.

Why can lead time be long even when cycle times look short?

Cycle time measures active processing. Lead time includes all waiting, queueing, batching, transportation, approval, and release delay. In many processes, active work is only 5-20% of total lead time.

How does WIP affect lead time?

Little's Law states that Lead Time = WIP / Throughput Rate. If throughput is fixed, more WIP means longer lead time. Reducing WIP is often the highest-leverage lead-time improvement.

Who should own the takt time calculation?

Operations leadership should own the resulting takt number, with inputs from production, planning, and engineering. The calculation should be documented and updated when inputs change.

What is the best way to use all three metrics together?

Use takt to set the required pace, cycle time to identify bottlenecks and station capability, and lead time to expose queues, WIP, batches, approvals, and handoff delays.

Quick Reference: Formula and Unit Guide

MetricFormulaNumeratorDenominatorResult Units
Takt timeNet available time / customer demandNet production minutes or hours in the period.Units demanded in the same period.Minutes/unit, seconds/unit, hours/job.
Cycle time from dataTotal operating time / total units producedObserved production time while running.Units produced during the observation window.Minutes/unit or seconds/cycle.
Cycle time directObserved time per cycleStopwatch start-to-finish measurement.One complete cycle.Minutes or seconds per unit.
Lead timeSum of all elapsed time componentsProcessing + queue + waiting + movement + delay.One unit or order.Hours, days, or weeks.
Little's LawWIP / throughput rateAverage units in the system.Units completed per time period.Hours or days of lead time.
Balance efficiencyTotal work content / (stations x bottleneck cycle time)Sum of station cycle times.Stations x bottleneck cycle time.Percentage.

Quick Calculation Reference Card

CalculationExample ValuesResult
Takt time: single shiftNet time = 420 min; demand = 140 units420 / 140 = 3.0 min/unit
Takt time: two shifts combinedNet time = 840 min; demand = 260 units/day840 / 260 = 3.23 min/unit
Cycle time from production dataStation ran 180 min; produced 55 units180 / 55 = 3.27 min/unit
Bottleneck checkCycle time = 3.27 min; takt = 3.0 min3.27 > 3.0; bottleneck cannot meet demand.
Line balance efficiency4 stations: 2.8, 3.1, 2.7, 3.0 min; bottleneck = 3.1 min11.6 / 12.4 = 93.5%
Lead time from Little's LawWIP = 180 units; throughput = 60 units/day180 / 60 = 3.0 days
Process efficiencyCycle time = 11 min; lead time = 2.8 days = 1092 min11 / 1092 = 1.0%; 99% is waiting.
Takt with demand increaseOriginal takt = 3.0 min; demand increases 25%New takt = 3.0 / 1.25 = 2.4 min/unit
Units possible at bottleneckNet time = 420 min; bottleneck cycle time = 3.4 min420 / 3.4 = 123 units, versus 140 demanded.

Quick Reference Summary: All Three Metrics

TopicTakt TimeCycle TimeLead Time
DefinitionThe pace required by customer demand.The actual measured time for one station, machine, or cell to complete one unit.Total elapsed time from request or order entry to receipt.
Core questionHow fast do we need to produce?How fast are we actually producing?How long does the customer wait?
What drives itCustomer demand and available production time.Process design, equipment, operator method, standard work, variation.Processing plus all queues, batches, transport, approvals, and delays.
FormulaNet available time / customer demand.Observed time per cycle or total operating time / units produced.Sum of all elapsed time components.
Primary useLine design, staffing, capacity planning, balancing anchor.Bottleneck identification, standard work, takt comparison.Customer responsiveness, flow performance, WIP assessment.
Improvement leversAdd capacity, add time, improve OEE, redesign line, smooth demand.Standard work, motion reduction, tooling, setup reduction, training, balancing.Reduce WIP, eliminate batching, simplify approvals, improve scheduling, pull systems.
Most common mistakeUsing gross time instead of net time.Reporting only average and not comparing to takt.Reporting processing time instead of true elapsed time.

Conclusion: Three Metrics, One System

Takt time, cycle time, and lead time are simple concepts that drive important decisions in Lean operations. Their simplicity is deceptive because confusing them leads to damaging outcomes: staffing plans built for the wrong pace, delivery promises based on processing time, and improvement projects aimed at operator speed when the real problem is flow.

A process with cycle time below takt but long lead time is telling you that flow is broken. A process with cycle time above takt is telling you that capacity is insufficient for current demand. A process with cycle time below takt and short lead time is the target condition: capable, balanced, and flowing.

Use takt time to know what you need. Use cycle time to know what you have. Use lead time to know what your customer experiences.

References and Further Reading

  • Rodgers, David. Takt Time, Cycle Time, and Lead Time Guide. SixSigmaKaizen.com, 2026.
  • Rother, Mike and Shook, John. Learning to See. Lean Enterprise Institute, 1998.
  • Womack, James and Jones, Daniel. Lean Thinking. Simon & Schuster, 1996.
  • Little, John D.C. "A Proof for the Queuing Formula L = Lambda W." Operations Research, 1961.
  • Lean Enterprise Institute, ASQ, and iSixSigma.

Apply This Next
